Uranium Scape
2024 · Architecture

Uranium Scape

Architecture · Research · Data Visualization

A speculative landscape that uses architecture to make the radioactivity of abandoned uranium mines in southern Texas visible — pairing GIS mapping and data visualization with built-form proposals for inhabitation and remediation.

100+
former uranium mines
4.5B yr
uranium decay span
3in–4ft
shielding wall thickness
100 yr
architecture life cycle

How can GIS mapping and data visualization reveal the history of uranium mining and inform rehabilitation strategies?

Architecture as an instrument to see radiation — Uranium Scape challenges the status quo of radioactive waste storage at abandoned uranium mines in southern Texas, using built form to reveal the radioactivity of the site, remediate the altered landscape, and re-imagine ways to inhabit the radioactive terrain.

The proposal layers two methods: GIS mapping and historical data visualization to read the site’s mining record, and a sequence of architectural moves that make the contamination legible to a visitor on the ground.

Site

Southern Texas holds over a hundred former open-pit uranium mines, most operated through the 1970s and 1980s. Before 1975, inadequate regulation led to improper disposal of radioactive waste. Mapping these sites by operational period reveals a dense cluster near the San Antonio River, and the project focuses on one of them: the Conquista Project (1971–1988) in Karnes County — a filled mining pit and a radioactive waste pile of uranium mill tailings and municipal waste. Despite being adjacent to a farmhouse and used for fishing and cattle grazing, the site carries no warning of its radioactivity. The design begins by drawing what is otherwise invisible: a plan of radiation contours (50, 100, 200 R/hour) that reasserts the waste pile and the former retention pond as things to be reckoned with.

Approach

A single linear building crosses the contaminated ground, acting as both a bio-remediation institution and a testing ground for re-inhabitation. Its section is organized by radiation exposure: hydroponics labs and researcher amenities sit farthest from the source, phytoremediation labs and composting occupy the center, and storage and monitoring press closest to the waste mound. Wall thickness varies from three inches to four feet, so the building’s own mass becomes a shielding gradient — the architecture registers the hazard it is built to withstand. A containment wall, monitoring wells, and an observation tower complete the infrastructure, while a phytoremediation field of sunflowers and hydroponic plants works to draw contaminants out of the soil and water.

Life cycle

The intervention is designed to expire. Over roughly a decade, the labs identify remediation plants and run continuous cycles of planting, harvesting for compost, and replanting. Once remediation succeeds, the labs are decommissioned and the site is left to natural growth; the building slowly crumbles, its core segments remaining as monuments on the artificial landscape. Set against uranium’s 4.5-billion-year decay, the hundred-year arc of the architecture is deliberately modest — a temporary instrument for making a permanent hazard visible, and for testing whether such a landscape can be lived with at all.

Title spread with a diagrammatic site plan reading — the linear building crossing between a former retention pond and the radioactive waste hill it reinhabits.
Title spread with a diagrammatic site plan reading — the linear building crossing between a former retention pond and the radioactive waste hill it reinhabits.

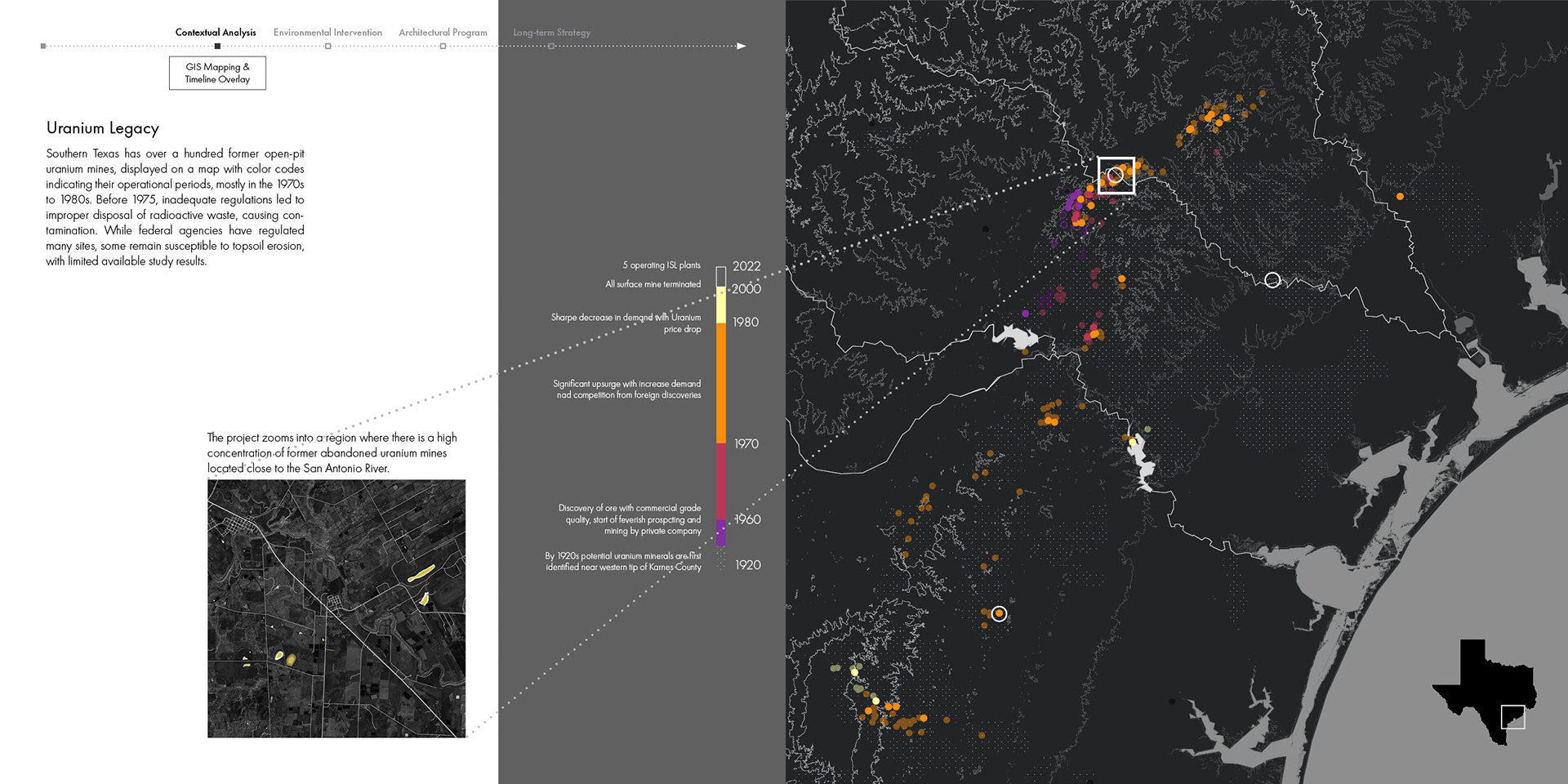

Contextual GIS map of southern Texas: over a hundred former open-pit uranium mines color-coded by operational period (1920–2022), zooming into a dense cluster near the San Antonio River.
Contextual GIS map of southern Texas: over a hundred former open-pit uranium mines color-coded by operational period (1920–2022), zooming into a dense cluster near the San Antonio River.

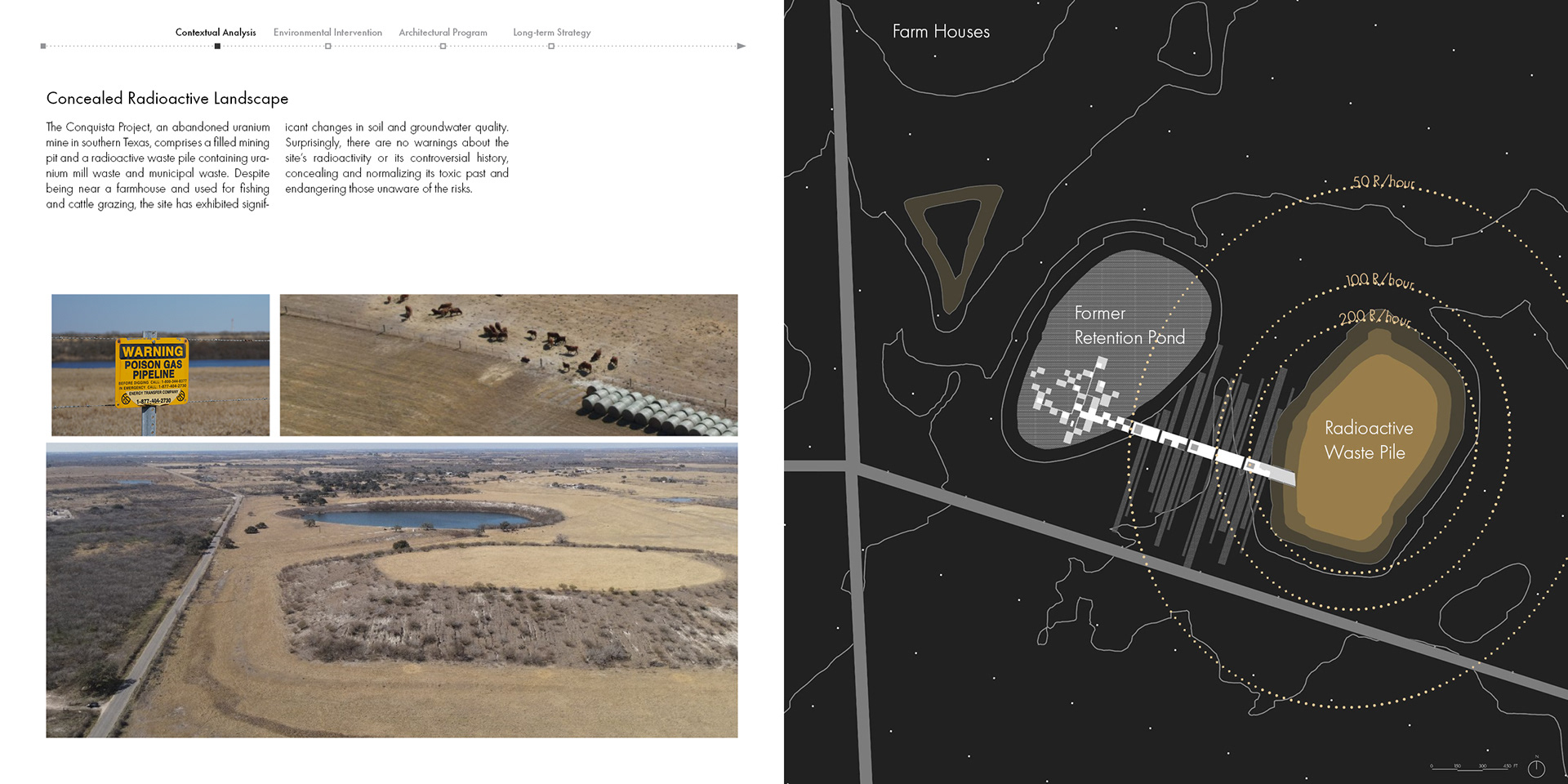

Site documentation of the Conquista Project — poison-gas pipeline warning, cattle grazing, and the filled mining pit — paired with a radiation-contour plan of the former retention pond and radioactive waste pile.
Site documentation of the Conquista Project — poison-gas pipeline warning, cattle grazing, and the filled mining pit — paired with a radiation-contour plan of the former retention pond and radioactive waste pile.

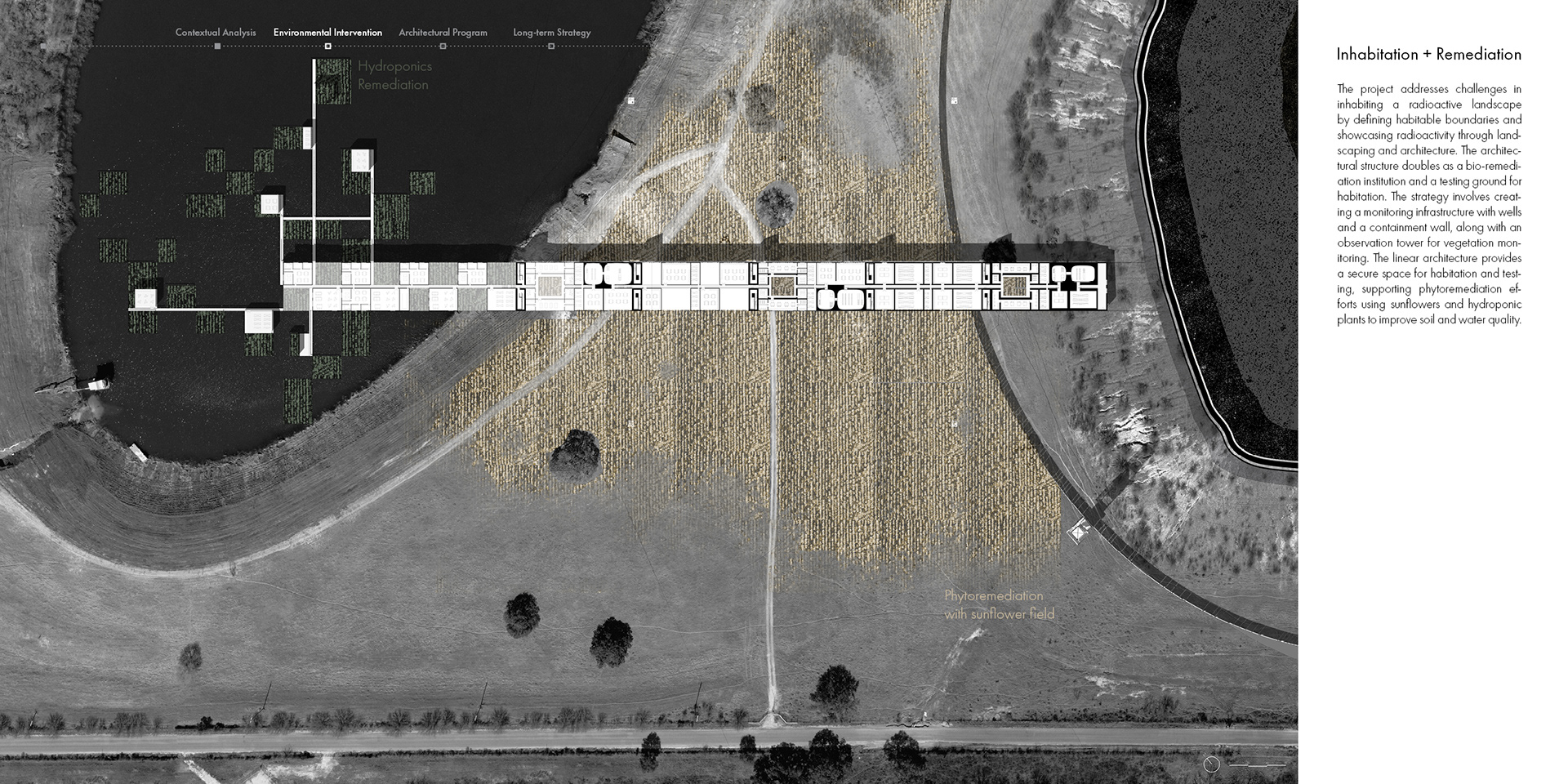

Roof/site plan of the linear intervention laid across the remediated landscape, with hydroponics remediation to one side and a phytoremediation sunflower field spanning the site.
Roof/site plan of the linear intervention laid across the remediated landscape, with hydroponics remediation to one side and a phytoremediation sunflower field spanning the site.

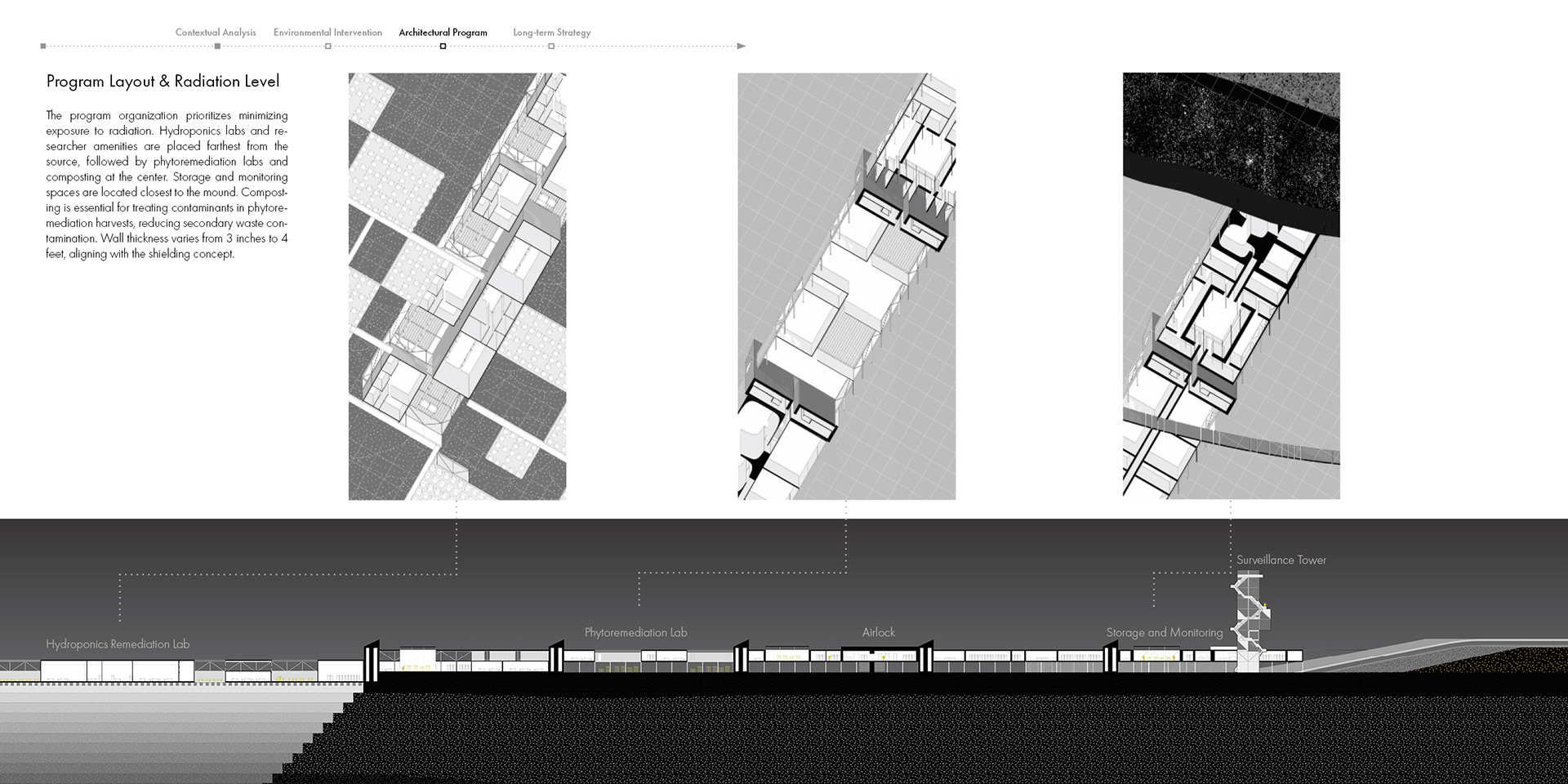

Program axonometrics and long section: hydroponics lab, phytoremediation lab, airlock, storage and monitoring, and surveillance tower, sequenced so wall thickness grows toward the radiation source.
Program axonometrics and long section: hydroponics lab, phytoremediation lab, airlock, storage and monitoring, and surveillance tower, sequenced so wall thickness grows toward the radiation source.

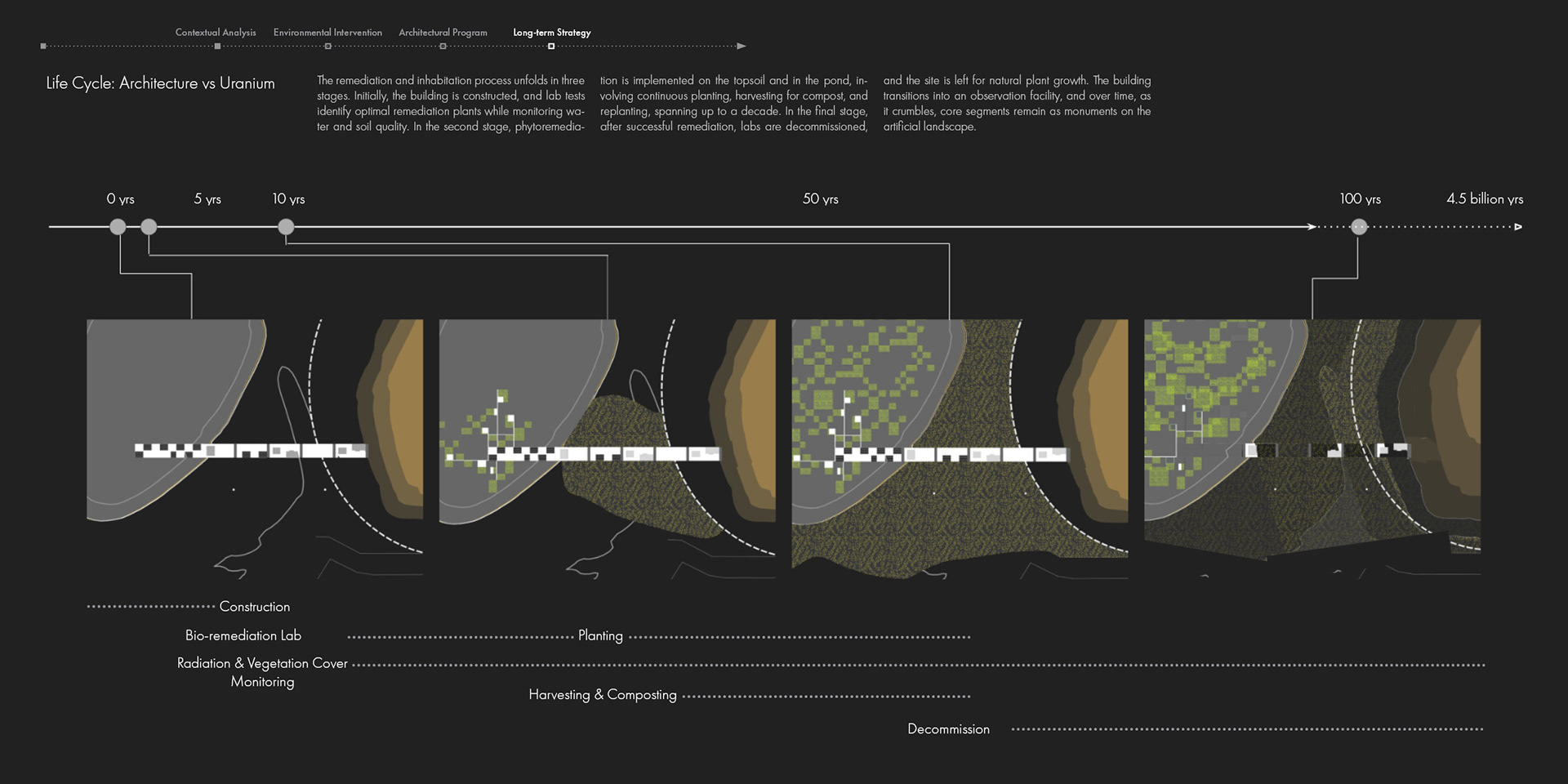

Life-cycle diagram — architecture vs. uranium — tracing construction, planting, harvesting/composting, and decommission across 0 to 100 years against uranium's 4.5-billion-year decay.
Life-cycle diagram — architecture vs. uranium — tracing construction, planting, harvesting/composting, and decommission across 0 to 100 years against uranium's 4.5-billion-year decay.
KEEP EXPLORING Explore the latent space
